Acceptance testing in business critical development projects is to make sure that the implementation is successful. All phases before acceptance can be agile. But if the acceptance phase is started before all the criteria is met, there will be problems.
Too often the problems are discovered during acceptance testing.
Usually the problem is passing the quality gate before the criteria for acceptance testing is met.

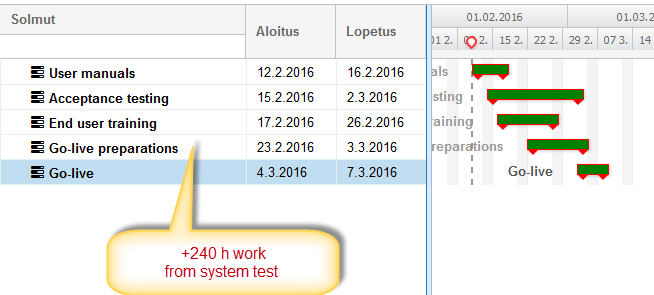

If there are 100 open errors to be fixed, it’s wrong to calculate that just by fixing them the system is ready. Even with normal quality, re-testing 100 errors produces around 40 new errors. Testing these errors produces again 10 new errors. –> If there are now a 100 errors that need fixing, the final number will be about 155 errors to be fixed for the system to be ready for the implementation. –> Processing and re-testing 155 errors takes about 240hrs client’s worktime. (There’s a post coming soon about the method to calculate this!)
The idea of acceptance testing is to make sure the implementation is done safely, without compromising the business. One could say it is a way to marvel how the solution supports the business. Testers are usually people from the business side, not testing professionals.

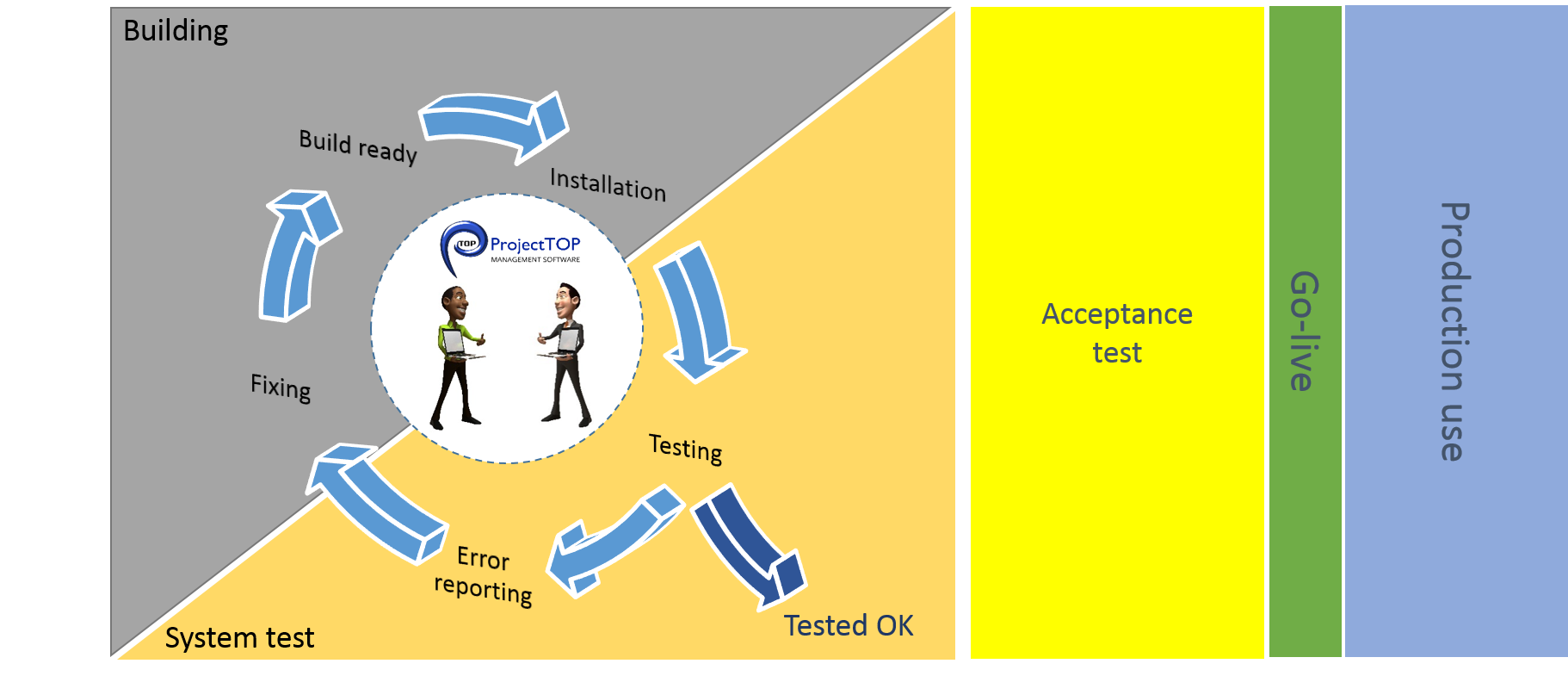

The picture below shows the situation where acceptance testing has started too early. If the project processes are ok, testers have been informed beforehand about what is not yet ready. Quite often testers still need to find that issue only to get feedback like “Oh yeah, that doesn’t work, there’s a change request open about it”.
Note
Or do we, or is it even smart?
Project is late, execution is not complete, errors have not been fixed. But if we change the schedule, there’s that threat that people stop working. Resources start working on something else with a tighter deadline. People believe in the miracle that when you start acceptance testing on schedule, the implementation can be done on schedule as well.
If you scheduled the acceptance testing to last three weeks, do you want that time to be used to work on unfinished tasks from previous phases as well?
Have you taken into account all those unfinished issues resource-wise? Keeping in mind that the unfinished issues slow down all progress.
Or would be better to first finish everything and then move on to acceptance testing? Which has less impact on implementation schedule?
Well there is always that possibility that everything works out perfectly fine ;-)
